Municipal Finance and Capacity Building (MFCB) Programme
Programme Status
Last Update: July 1, 2022 |
|
Start Date: 1 Feb 2019 |
|
Expected Completion Date: 31 January 2023 |
|
Total Activities: 49 |
|
Completed Activities: 7 |
|
Output level Progress status
A. Physical Progress
Progress Status |
Progress % |
Completed Activities |
Output1: Enhanced capacity of municipalities to develop/ update long term strategic plan |
27 |
1. Inception Workshop (1.1.1) 2. Procurement and Contract Management Training (1.1.8) |
Output2: Enhanced Capacity of municipalities to develop investment pipeline for improved urban infrastructure and services |
29 |
3. Conduct pre-feasibility study for potential investments (2.1.2)
|
Output3: Enhanced Capacity of municipalities to develop investment pipeline for improved urban infrastructure and services |
28.3 |
|
Output4: Enhanced Capacity of municipalities to develop investment pipeline for improved urban infrastructure and services |
30 |
4. Support for preparation of Municipal Investment Facility guidelines including revision of existing common loan and grants policy (4.2.1) 5. Develop loan recovery policy and guidelines for TDF (4.2.2) 6. Develop PPP financing policy, manual/guidelines for TDF (4.3.2) 7. Conduct Study on gap analysis between best practices of other relevant municipal development banks and TDF (4.1.2) |

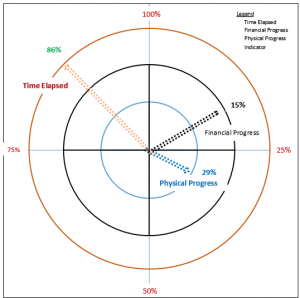

Average Physical progress, % as of June 2022 |
29 |
|
MFCB Activities Progress Status
Ref No. |
Activities |
Expected Completion Date |
Progress, % |
Status |
Plan |
1.1.1 |
Inception workshop |
|
100 |
Complete |
|
1.1.2 |
Support for preparation and review of municipal Strategic Plan and Profiling |
June-22 |
33 |
5-IUDPs Review |
Review and report findings- 10 IUDPs |
1.1.3 |
Support for preparation of common LED Strategy for municipalities |
July-22 |
5 |
Document complete for procurement |
Once LED document from MOFAGA; will be materialized |
1.1.4 |
Municipal Financing Strategy Developed |
Autust-22 |
15 |
RFP Evaluation |
Contract agreement |
1.1.5 |
Training and Preparation of Medium Term Expenditure Plan for the Municipality |
Autust-22 |
15 |
RFP Evaluation |
Contract agreement |
1.1.6 |
Training and Preparation of Capital Investment Plan and Asset Management Plan |
Autust-22 |
15 |
RFP Evaluation |
Contract agreement |
1.1.7 |
Prepare Revenue Improvement Action Plan (RIAP) |
June-22 |
70 |
Gorkha-final report; Hetauda-consultant mobilized and Birendranagar-Inception report received |
Follow up consultants for Hetauda and Birendranagar |
1.1.8 |
Procurement and Contract Management Training |
|
100 |
Complete |
|
1.1.9 |
Support Preparation of Procurement Plans |
August-22 |
0 |
– |
Plan and expedite |
1.1.10 |
Prepare ICT based Guidelines and procedure document for IPT/Business Tax and House Rent Tax |
Autust-22 |
15 |
Document complete for procurement |
Proceed for procurement |
1.1.12 |
Conduct seminars/workshops for advocating climate resilient and sustainable urban infrastructures |
September-22 |
20 |
Training of in house staff completed. Preparation for the event |
Proceed training event |
1.1.13 |
Organize workshops to prepare civic education materials on disaster risk reduction for CBOs |
September-22 |
20 |
Event preparation completed |
Proceed training event |
1.2.1 |
Support Selected pilot municipalities in automation of financial reporting including expenditure tracking system |
August-22 |
0 |
Pilot municipalities selected |
Write a concept note and prepare plan for support to pilot municipalities |
1.2.2 |
Support pilot municipalities in designing and implementing street addressing system and house numbering system |
April-22 |
35 |
Inception report submitted |
Proceed for procurement |
1.2.3 |
Support to establish database of key taxes and service delivery in selected pilot municipalities |
November-22 |
15 |
Evaluation Stage ( merging with 1.2.5) |
Contract agreement |
1.2.4 |
Introduce e-building permit system |
September-22 |
15 |
Notice publishing stage |
Issue RFP |
1.2.5 |
Support ICT-based municipal service delivery |
November-22 |
15 |
Evaluation Stage ( merging with 1.2.3) |
Contract agreement |
1.2.6 |
Conduct advanced ICT Training to key officials of selected pilot municipalities for implementation of integration of revenue and service delivery |
August-22 |
5 |
Dhulikhel Municipality ward no 4 has been selected to be piloted |
Finalize concept for the training |
|
|
|
|
|
|
2.1 |
Support Project Development |
|
|
|
|
2.1.1 |
Training and support on project development, including checklist, screening and prioritization of potential projects |
November-22 |
15 |
Guideline under preparation |
Finalize the Guideline |
2.1. 2 |
Conduct pre-feasibility study for potential investments |
|
|
Complete |
|
2.1.3 |
Prepare Detailed Project Reports for bankable investment projects |
September-22 |
15 |
ToR finalized-RFP process |
Proceed for RFP |
2.1.4 |
Support Design and Finance for urban regeneration including land development |
October-22 |
15 |
ToR finalized-RFP process |
Proceed for RFP |
2.1.5 |
Develop feasibility/DPR project pipeline for Smart Water Grid (SWG) |
August-22 |
0 |
Preliminary discussion held, waiting for concept note |
Coordinate with the team-Municipality, water supply board |
|
|
|
|
|
|
3.1.1 |
Training on Participatory planning and budgeting process |
June-22 |
0 |
Concept note under process in line with MOFAGA “local level budgeting and planning working procedure” |
Prepare concept note |
3.2.1 |
Support municipalities to prepare communication strategy for citizen engagement and public accountability in municipal services and taxation |
August-22 |
55 |
Inception report submitted |
Contract administration |
3.2.2 |
Support mechanisms to disclose key information in the municipality website in accordance with Right to Information Act |
January-23 |
10 |
Concept note developed |
Conduct web based information sharing |
3.2.3 |
Support to ensure public hearing are conducted |
January-23 |
80 |
Public hearing-Notes collected from concerned municipalities |
|
3.2.4 |
Prepare common Grievance handling policy and operation manual for municipality |
Autust-22 |
25 |
Consultant mobilized on February |
Contract administration |
3.2.5 |
Support CSO capacity for demand of services |
March-22 |
0 |
– |
Prepare concept note |
|
|
|
|
|
|
4.1 |
Support actions on non-grant financing products |
|
|
|
|
4.1.1 |
Conduct Credit Rating Assessment of TDF |
October-22 |
20 |
Consultant mobilized |
Contract administration |
4.1.2 |
Conduct Study on gap analysis between best practices of other relevant municipal development banks and TDF |
September-22 |
100 |
Final Report submitted |
|
4.1.3 |
Strengthen TDF’s online municipal project finance application system |
December-22 |
10 |
Concept note finalized |
Prepare consulting report |
4.1.4 |
Strengthen database and M/E system of TDF |
December-22 |
20 |
AMS contracting phase-system development phase |
Draft concept note |
4.1.5 |
Strengthen TDF’s Appraisal System |
August-22 |
20 |
Contract signed |
Contract agreement |
4.1.6 |
Preparation of DPR of model green building |
August-22 |
20 |
RFP stage |
complete evaluation and proceed for procurement |
4.1.7 |
Provincial workshop conducted in 7 provinces on TDF’s Business Products, Services and application procedures tec. |
December-22 |
71 |
Supplementary workshop planned to conduct on September |
|
4.1.8 |
Support the preparatory works for bond issuance strategy and guidelines |
June-22 |
0 |
– |
Sr. Banker will work out while on board |
4.1.9 |
Conduct Market Study for bond issuance |
June-22 |
0 |
– |
Sr. Banker will work out while on board |
4.2.1 |
Support for preparation of Municipal Investment Facility guidelines including revision of existing common loan and grants policy |
|
100 |
Complete |
|
4.2.2 |
Develop loan recovery policy and guidelines for TDF |
|
100 |
Complete |
|
4.2.3 |
Develop Impact Investment Strategy and Operation systems |
May-22 |
0 |
– |
Draft ToR |
4.2.4 |
Develop Potential Impact Investment Concept Notes (related to climate resilient urban infrastructure) for implementation |
January-22 |
30 |
3 Concept notes have been produced |
3 Concept notes have been produced |
4.2.5 |
Develop feasibility studies and DPRs for climate resilient urban infrastructure |
June-22 |
15 |
ToR for detailed tudy finalized |
Proceed for RFP with revisiting ToR |
4.2.6 |
Support advocacy and policy intervention on various related thematic areas including energy efficiency investments |
June-22 |
0 |
– |
NEEP regular program-energy audit |
4.2.7 |
Conduct workshops and conferences on lessons learned from the MFCB pertaining to municipal finance |
January-23 |
0 |
– |
Draft concept note, and discussion models |
4.3.1 |
Conduct workshop and initiation of PPP for high impact projects |
October-22 |
0 |
– |
Develop concept note and workout while PPP Expert on board |
4.3. 2 |
Develop PPP financing policy, manual/guidelines for TDF |
|
|
Complete |
|
4.4 |
Conduct Impact Assessment of sector wise projects supported by TDF (Water Supply, Bus Park and Commercial Complex) including TDF’s contribution to the national economy |
July-22 |
25 |
Contract signed |
Contract administration |
4.5 |
Conduct Study on TDF’s role, opportunities and challenges in the changed federal context |
June-22 |
0 |
– |
Draft ToR |
4.6 |
Conduct Twinning Programme with an International Agency working on municipal infrastructure financing institution, such as Netherlands Municipal Bank (BNG) and Exposure Visits 18 personnel for Capacity Development |
0 |
– |
|
B. Financial Progress
Budget Heading |
Total Cost |
Total Cost |
Cumulated costs (before current report) (EUR) |
Cumulated costs (from start of implementation to present report included) (EUR) |
Balance (EUR) |
1. Human Resources |
176,610 |
26,716 |
– |
26,716 |
149,894 |
2. Travel |
47,987 |
2,124 |
– |
2,124 |
45,863 |
3. Equipment and supplies |
411,677 |
3,090 |
77,902 |
80,993 |
330,684 |
4. Local office |
31,672 |
11,567 |
2,228 |
13,796 |
17,877 |
5. Other costs, services |
978,770 |
43,132 |
11,732 |
54,864 |
923,905 |
6. Other |
291,780 |
79,451 |
8,922 |
88,372 |
203,407 |
Total |
1,938,495 |
166,080 |
|
266,865 |
1,671,630 |
|
|
|
|
13.77% |
|
